Tile Roof Underlayment Replacement in Pompano Beach, FL

  • Typical cost: HomeGuide's national range is $0.75 to $4 a square foot, or about $1,500 to $8,000 for a 2,000 sq ft roof.
  • Time on the roof: relaying the tile is a full tile installation, which HomeGuide puts at 3 to 5 days for most roofs.
  • Lifespan: asphalt felt lasts about 20 to 30 years and synthetic or rubberized underlayment 25 to 30, well short of the tile.
  • Thickness: Florida's tile installation manual calls for self-adhered membrane of at least 40 mil.

Pompano Tile Roofing arranges for an independent roofer to lift a few tiles and look at the underlayment before anyone prices a whole new roof. Tile roof underlayment replacement swaps out the worn waterproof layer and puts your own tile back on top, with new pieces for any that crack.

Tile Roof Underlayment Replacement Methods and Materials

Concrete S-tiles lifted and stacked in neat rows along the ridge while new black underlayment covers the lower half of the roof

Lift and relay (tile reused)

Some roofers call this job lift and relay: the tiles come off, new underlayment goes down, and the original tiles are set back. It works because tile usually outlasts the layer under it. Everything else about a re-roof still applies once the deck is bare, from rotted sheathing that has to be replaced to the permit and inspections. The City inspects the new underlayment before the tile goes back.

  • Per 100 square feet: HomeGuide prices relaying the same tile over new felt at about $650 to $1,400.

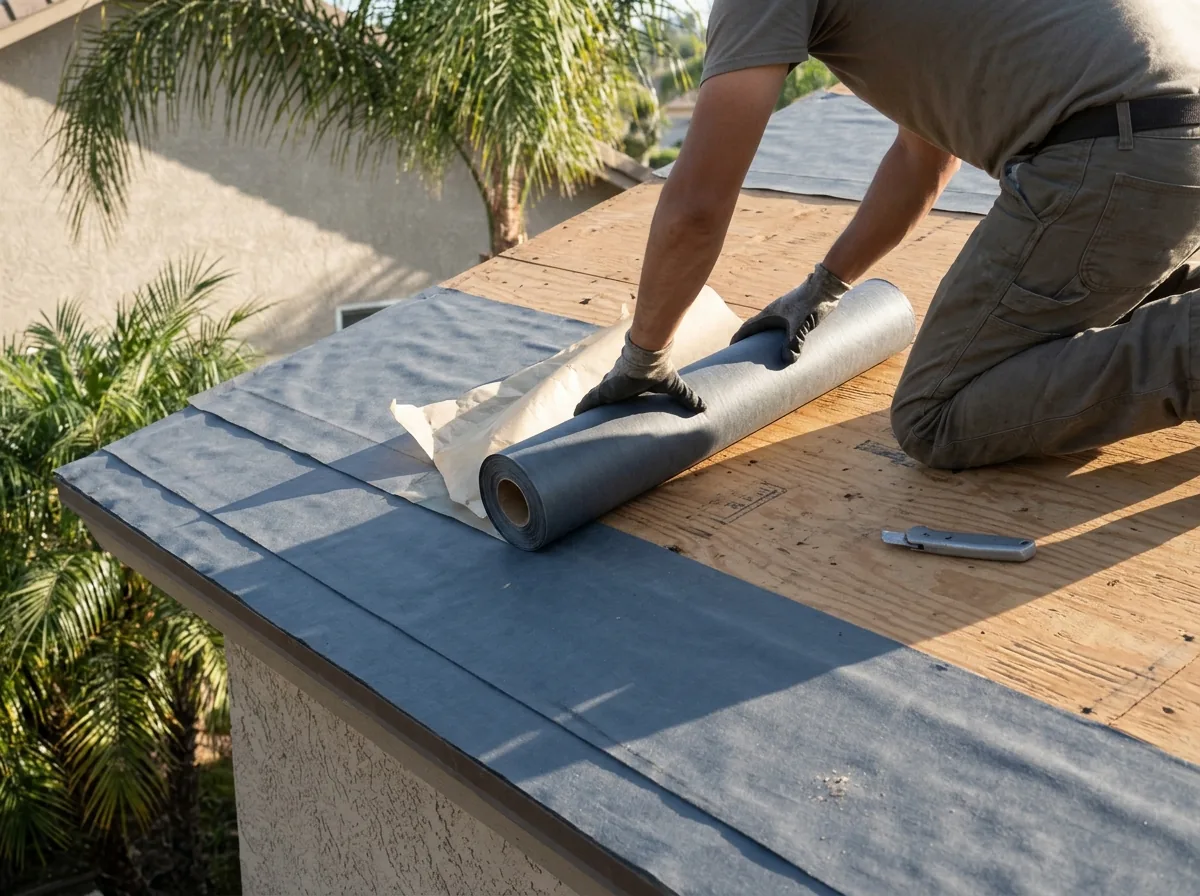

Roofer seen from behind rolling out a peel-and-stick underlayment membrane across bare plywood on a tile roof

Self-adhered underlayment

Peel-and-stick membrane bonds straight to the deck. The FRSA-TRI manual calls one layer of it a single-ply system and sets a 40 mil minimum in SBS, APP or an approved equal. It's also the one type the state's wind mitigation form counts as secondary water resistance, as long as it's fully adhered and meets ASTM D1970; the inspection page covers what that credit means.

  • Material only: rubberized SBS about $0.20 to $0.90 a square foot.

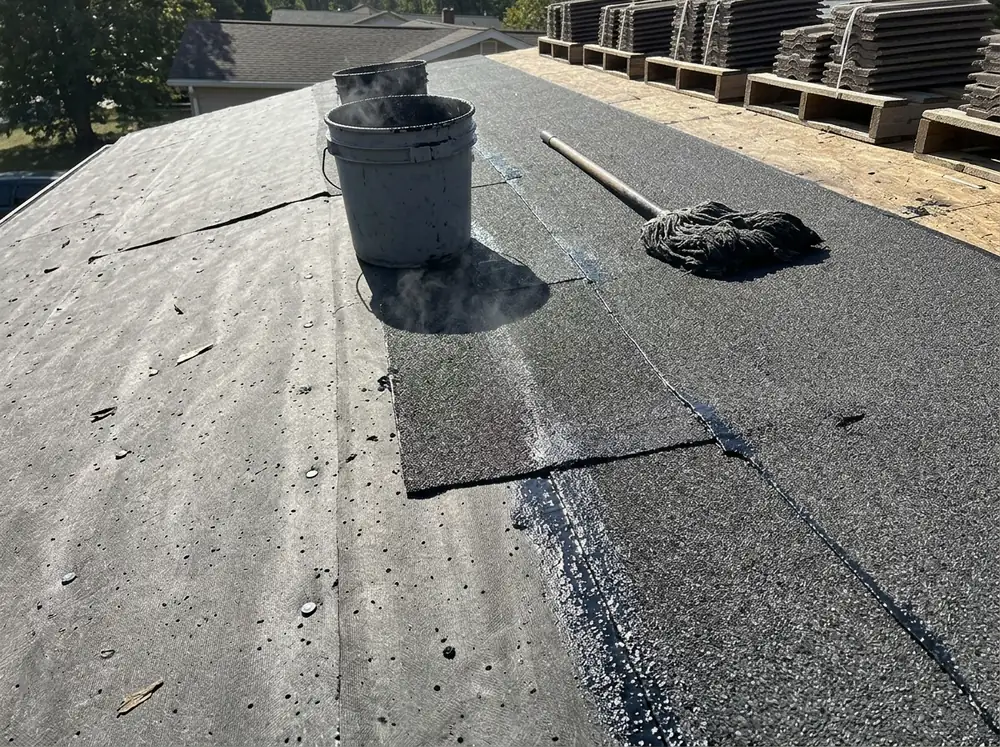

Two-ply roof underlayment with a mineral cap sheet set in hot asphalt over a nailed base sheet, tile not yet loaded

Hot-mopped underlayment

Hot mop is a two-ply system: a base sheet on the deck, then a cap sheet set in hot asphalt. Under the manual, cap sheet headlaps are at least 3 inches and back-nailed every 12 inches. The HVHZ inspection list includes one during or after the base sheet and another while the cap sheet goes on. The state form says hot-mopped felts don't count as secondary water resistance, which matters if you're chasing a wind mitigation discount.

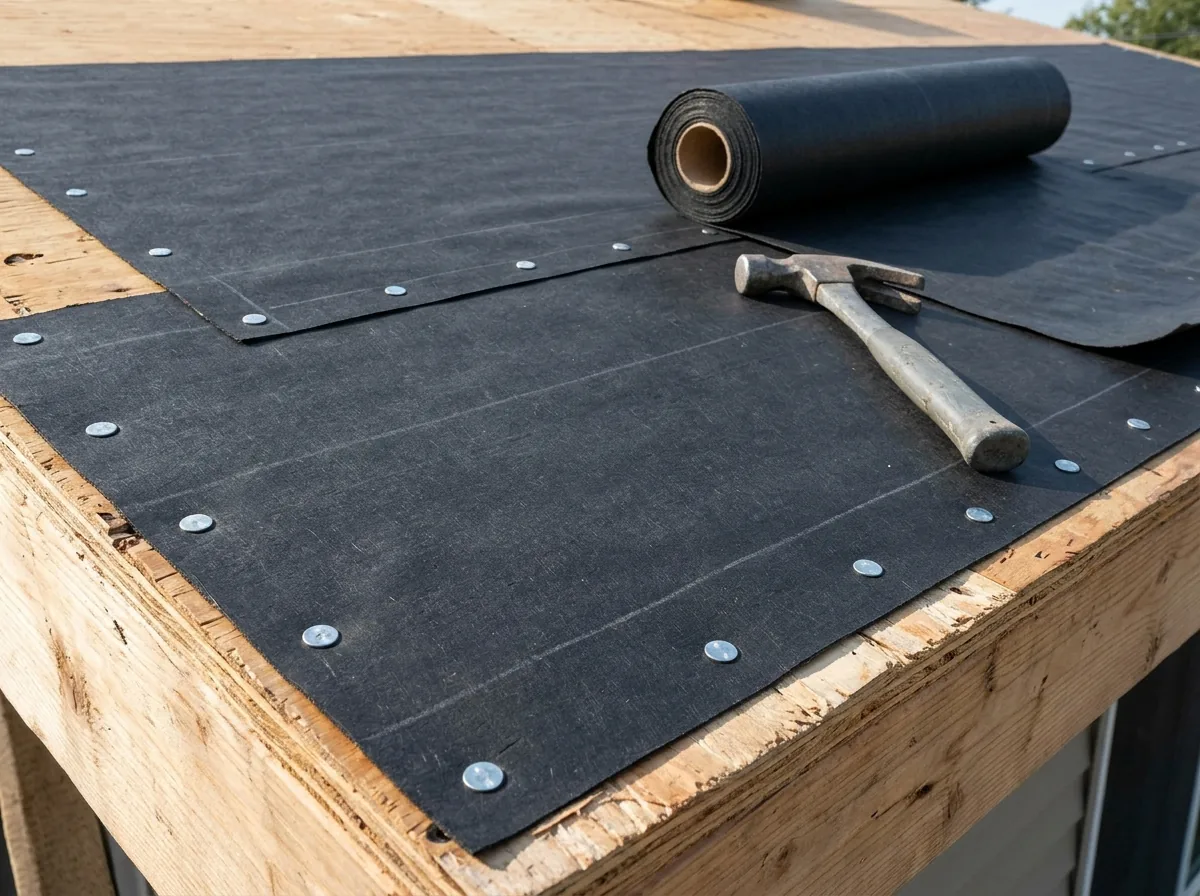

Base sheet nailed to plywood decking with round metal tin caps in rows, a roll of underlayment beside it

Mechanically fastened and synthetic underlayment

In a two-ply system the base sheet can be nailed instead of stuck down, with the cap sheet adhered over it. In the HVHZ those nails are ring-shank and go through tin caps 1 5/8 to 2 inches across, or a cap nail that meets the same test. Synthetic and felt sheets are cheaper by the square foot, and a This Old House source suggests polypropylene for hot, sunny climates. Any tile underlayment has to pass the FM 4474 or UL 1897 uplift test.

  • Material only: felt about $0.05 to $0.15 a square foot; synthetic about $0.10 to $0.35.

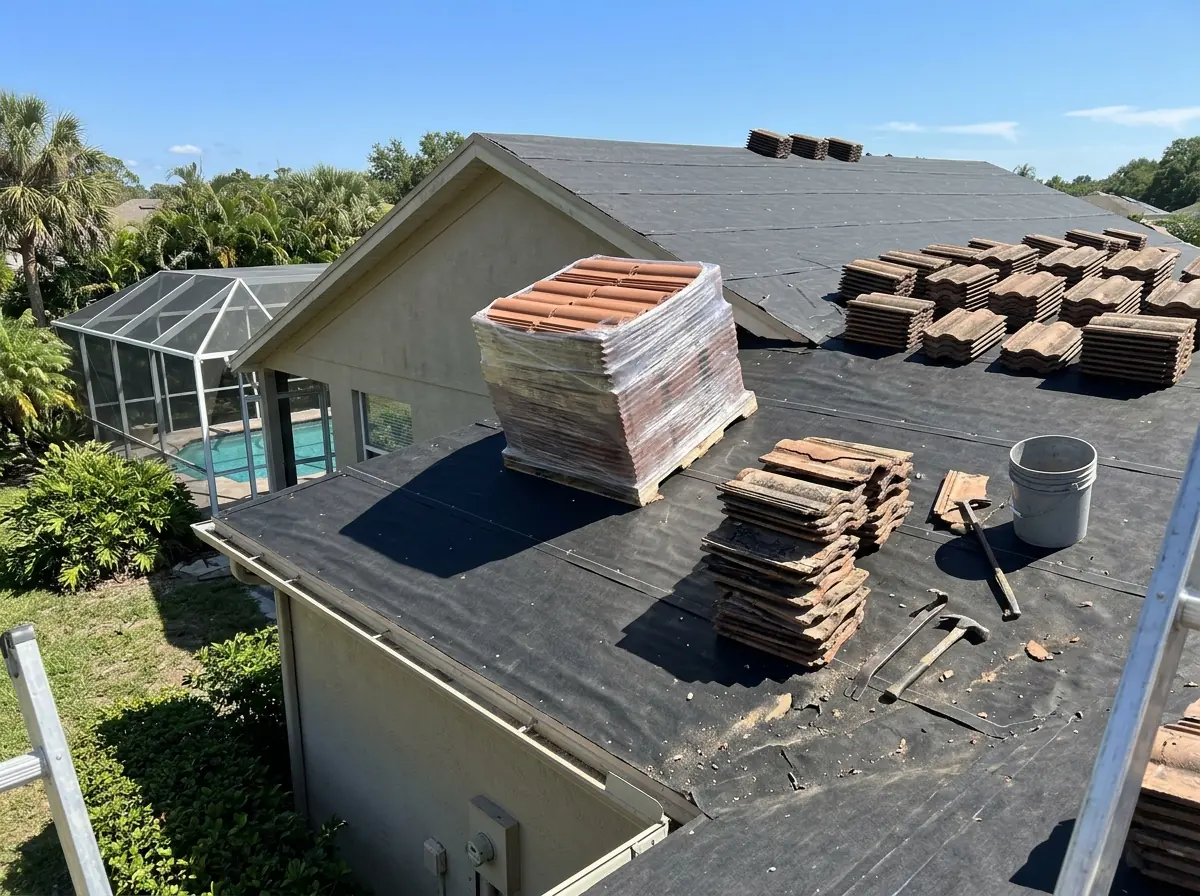

Pallet of matching new concrete S-tiles on the roof next to a short stack of cracked tiles set aside during a relay

Replacing tiles that break during the relay

Some tile breaks when it's lifted, stacked and reset, and Florida's code doesn't allow cracked or broken tile back on. Salvaged tile can fill gaps only if it matches the original in material and profile. Older concrete profiles may be out of production, so finding matching tile is worth sorting out before tear-off.

  • New tile: a pallet costs about $1,100 to $1,400 and covers roughly 250 to 350 square feet.
Gloved hands setting a new clay barrel tile onto foam adhesive paddies over underlayment

Why Pompano Beach homeowners call Pompano Tile Roofing

  • Free to call, free to request a quote
  • One independent local tile roofer per request, not a bidding list
  • Ask for tear-off, underlayment, deck repair and permit on one written price
  • Your details go only to the roofer handling your request

Get a free tile roofing estimate

Free for homeowners. One local contractor contacts you.

Underlayment Replacement Cost by Roof Size

HomeGuide's figures are national and include labor; This Old House quotes underlayment alone at $0.50 to $2 a square foot.

Roof area Typical underlayment replacement
2,000 sq ft $1,500 to $8,000
2,500 sq ft $1,900 to $10,000
Overall range $1,100 to $9,000

HomeGuide ties the spread to the underlayment type, the roof size and the condition of what's under it. On a quote, the lines that move most are rotted decking, the allowance for broken tile and the permit.

What to Settle Before the Tile Comes Off

  • The system by name

    Single-ply or two-ply, the product, and its Florida Product Approval or NOA number.
  • The deck

    The City doesn't have to inspect renailing, so ask for photos of the bare deck and of any sheets replaced.
  • Breakage allowance

    How many replacement tiles the price includes, and where they'll come from.
  • Payment terms

    The Florida deposit rule on a tile roof replacement applies here too; get the schedule in writing.

Pompano Tile Roofing sends your roof details to one roofer; ask for a few tiles to be lifted so you can see the underlayment before deciding on a relay. See tile roof leak repair if a single leak is the only problem so far.

Frequently asked questions

What underlayment goes under a tile roof in Broward County?

The FRSA-TRI Florida High Wind manual describes two systems: a single ply of self-adhered membrane straight on the deck, or two plies, a base sheet with a cap sheet over it. Both call for at least 40 mil SBS, APP or an approved equal, and in the HVHZ the product needs a current approval.

How do I know the underlayment under my tile is worn out?

Age and leaks with no broken tile are the usual clues. Felt is rated for about 20 to 30 years, and the tile above it lasts longer. Ask the roofer to lift a few tiles in a valley or at the eave and show you whether the underlayment has dried out, cracked or torn.

Is self-adhered underlayment better than hot-mopped?

Both meet code when installed per the manual. The difference shows up on insurance: the state wind mitigation form gives a secondary water resistance credit for fully adhered ASTM D1970 membrane but says hot-mopped felts don't qualify. That form is explained on the inspection page.

Can new underlayment go over the old layer?

Usually the old layer comes off. The code's tile section has one exception: an existing self-adhered modified bitumen underlayment can stay if the deck renailing is confirmed, with a full two-ply system over it. Ask the roofer whether the City accepts that on your HVHZ permit.

How many tiles break during a lift and relay?

No guide gives a fixed share, but HomeGuide warns that extra tiles break during tile work. Cracked tiles can't go back on, so budget for some new or salvaged tile. A pallet runs about $1,100 to $1,400 and covers roughly 250 to 350 square feet.
